1919 MARKET DEVELOPMENT
< Update 07/01/2020
-
Construction continues on schedule.
-
Most exterior work done and only finish work really left.
End Update >>
< Update 06/15/2020
-
Construction continues on schedule.
-
Interior finish work for drywall and insulation throughout.
-
No issues, no compliants.
End Update >>
< Update 06/01/2020
-
Construction continues on schedule.
-
Offsite utility infrastructure began on Market Street
-
No Issues no complaints
End Update >>
< Update 05/15/2020
-
Construction continues on schedule.
-
Windows being prepared for Myrtle Street building.
-
Walkways being prepared for metal grating.
End Update >>
< Update 05/01/2020
-
Construction continues on schedule.
-
Exterior stairs being constructed.
-
Footings being poured for stairs.
End Update >>
< Update 04/15/2020
-
Construction continues and has slowed due to COVID rgulations.
-

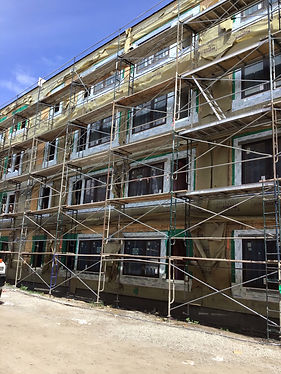

Windows are installed at 50% of building.
-
No issues no complaints.
End Update >>
< Update 04/01/2020
-
COVID regulations are in affect.
-
Elevator pits and shafts are constructing
-
work force down-sized due to COVID regulations
End Update >>
< Update 03/15/2020
-
Construction continues on schedule.
-

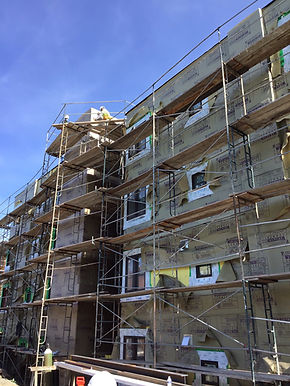

Windows are installed for 50% of building
-
Intumescent 1 hour rated paint for exterior walkways started.
End Update >>
< Update 03/01/2020
-
Construction continues on schedule.
-

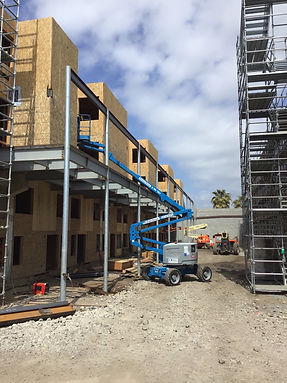

Framing has completed and second floor walkways being built.
-
No site issues; No complaints
End Update >>
< Update 02/14/2020
-
Construction continues on schedule.
-

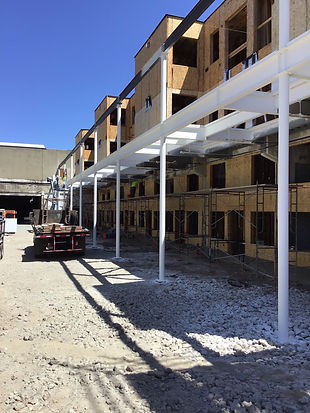

Steel walkways have begun building at courtyards
-
No site issues; No complaints
End Update >>
< Update 02/01/2020
-
Construction continues on schedule.
-

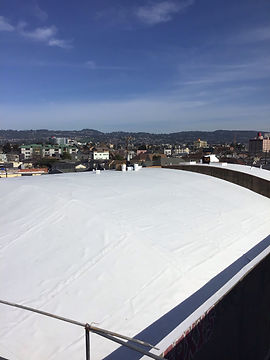

Roofs have installed on barrel vault roof.
-
Concrete podium poured on 3rd floors of Market and Myrtle buildilngs.
End Update >>
< Update 02/01/2020
-
Construction continues on schedule.
-
No major updates; No complaints
End Update >>
< Update 01/07/2020
-
Construction continues on schedule.
-
Owner's Project Manager performed new weekly added site walk for any site issues previously brought up by neighbors and checked rain and tracking concerns. No issues were found.
-
Future community updates are intended to be by website and by physical flyer, monthly. The need for ongoing community meetings no longer are needed.
End Update >>
< Update 12/17/2019
-
Construction continues on schedule.
-
Owner's Project Manager performed new weekly added site walk for any site issues previously brought up by neighbors and checked rain and tracking concerns. No issues were found.
-
Future community updates will be sent out digitally. The need for ongoing community meetings no longer are needed.
End Update >>
< Update 12/03/2019
-
Construction continues on schedule.
-
Owner's Project Manager performed new weekly added site walk for any site issues previously brought up by neighbors and checked rain and tracking concerns. No issues were found.
-
Reminder of monthly community meeting on 12/3/2019. Location is at De Fremery Park at 5:30pm.
End Update >>
< Update 11/22/2019
-
Construction continues on schedule.
-
Owner's Project Manager performed new weekly added site walk for any site issues previously brought up by neighbors. Dust screening fell at Myrtle street side scaffolding. Screen was repaired same day. No other issues found.
-
Flyers were sent out for monthly community meeting update for the next meeting on 12/3/2019. Location is at De Fremery Park at 5:30pm.
End Update >>
< Update 11/15/2019
-
Construction continues on schedule.
-
Owner's Project Manager performed new weekly added site walk for any site issues previously brought up by neighbors. No problems found.
End Update >>
< Update 11/08/2019
-
Construction continues on schedule.
-
Owner's Project Manager performed new weekly added site walk for any site issues previously brought up by neighbors. No problems found.
End Update >>
< Update 10/31/2019
-
Construction continues on schedule.
-
2 of 4 buildings are framed up in wood. The last two buildings will be framed up in December.
-
Letter to neighbors with summary of all mitigations over course of construction project.
-
Next community meeting update on 11/5 @ 5:30pm @ De Fremery Park.
End Update >>
< Update 8/13/2019
-
Complaint Log provided and updated continuously.
-
Daily Activity Log provided and updated continuously. Please follow for construction progress.
End Update >>
< Update 7/31/2019
-
Complaint Log provided and updated continuously.
-
Daily Activity Log provided and updated continuously. Please follow for construction progress.
End Update >>
< Update 6/11/2019
-
See new contacts for site management going forward.
John Randall - Senior Site Superintendent
(510) 394-5747
Carlie Hernandez - Senior Project Manager
(510) 423-3124
End Update >>
< Update 6/5/2019
-
For all that have concerns and complaints please reach out to Owner directly. Many of these concerns can be taken care of. New signs are going up on both Myrtle and Market with the website information, and contact information of relevant parties. Please reach out to Owner, first, before sending to City and County, as many of these items can be taken care of directly.
< Update 6/1/2019
-
Construction continues.
-
Concrete is about 75% complete
-
Demo is 85% complete
-
Plumbing is 25% in the ground
New schedule provide below:
End Update >>
< Update 5/25/2019
-
Air and Dust Monitoring continue daily
-
Concrete is about 70% complete
-
Demo is 80% complete
-
Plumbing is 20% in the ground
-
Framing has begun in Area A
End Update >>
< Update 5/18/2019
-
Air and Dust Monitoring continue daily
-
Concrete is about 70% complete
-
Demo is 80% complete
-
Plumbing is 15% in the ground
-
CMU has begun in Area A
End Update >>
< Update 5/11/2019
-
Air and Dust Monitoring continue daily
-
Concrete is about 65% complete
-
Demo is 75% complete
-
Plumbing is 10% in the ground
End Update >>
< Update 5/04/2019
-
Air and Dust Monitoring continue daily
-
Concrete is about 60% complete
-
Demo is 65% complete
-
Plumbing is 5% in the ground
-
VMS and Geoseal has begun
End Update >>
< Update 4/27/2019
-
Air and Dust Monitoring continue daily
-
Concrete is about 55% complete
-
Demo is 60% complete
-
Plumbing is 5% in the ground
End Update >>
< Update 4/20/2019
-
Air and Dust Monitoring continue daily
-
Concrete is about 50% complete
-
Demo is 55% complete
-
Plumbing has started in the ground
End Update >>
< Update 4/13/2019
-
Air and Dust Monitoring continue daily
-
Concrete is about 45% complete
-
Demo is 50% complete
End Update >>
< Update 4/06/2019
-
Air and Dust Monitoring continue daily
-
Concrete is about 30% complete
-
Demo is 45% complete
End Update >>
< Update 3/30/2019
-
Air and Dust Monitoring continue daily
-
Concrete is about 25% complete
-
Demo is 40% complete
End Update >>
-
Air and Dust Monitoring continue daily
-
Concrete is about 15% complete
-
Demo is 35% complete
End Update >>
< Update 3/15/2019
-
Construction continues.
-
Concrete has started preliminary work in NE Building.
-
Demo continues to remove portions of existing facades
End Update >>
< Update 3/08/2019
-
Construction is 2 months into a 20 month construction period.
-
Weekly logs of Remedial Action and Construction below - Also on Geotracker
Fact Sheet for Remediation Updates
End Update >>
< Update 3/01/2019
-
Construction is going smoothly.
-
Concrete is planning to begin in the next couple weeks
-
Demolition has mostly completed. All work has been tracked with air and dust monitoring during this entire period.
End Update >>
< Update 2/22/2019
-
Demolition continues.
-
No additional updates or concerns at this time.
-
End Update >>
< Update 2/13/2019
-
Construction is 1 month into a 20 month construction period.
-
Weekly logs of Remedial Action and Construction below - Also on Geotracker
ACDEH Correspondence Directive 2/1
-
General construction updates:
-
Site is fully graded
-
Demolition has about 2 more weeks until completed
-
Excavation for utilities and structural foundation to begin in the next week
-
Air and Dust Monitoring have been in effect throughout.
-
-
See current schedule below
End of update >>
< Update 2/06/2019
-
Demolition continues.
-
Contractor continues to put safety measures in place across site.
-
End Update >>
< Update 1/30/2019
-
Construction began 3 weeks ago. Project is 20 months.
-
Weekly logs of Remedial Action and Construction below - Also on Geotracker
-
General construction updates:
-
Site preparation has begun
-
Demolition of above ground structures
-
Site Grading has been nearly completed.
-
Air and Dust Monitoring have been in effect throughout.
-
End of Update>
< Update 1/25/2019
End of Update>
< Update 1/18/2019
End of Update>
< Update 1/11/2019
End of Update>
< Update 1/11/2019
End of Update>
< Update 1/02/2019
-
Construction has begun.
-
Site preparation for the next couple weeks.
-
Trailer and temp power in the next couple weeks.
-
Light demo in the next couple weeks.
End of Update>
< Update 12/13/2018
-
All Permits needed to start construction have been pulled and approved
-
Development is anticipating to start site preparation, mobilization, and securing the site for construction on 12/20.
-
Construction is anticipating to officially start 1/2/2019.
-
New boards with updated information on emergency contacts to be installed 12/17. General Information:
-
General Contractor: Michael Roberts Construction
-
For all construction, demolition, and above grade environmental concerns contact:
-
Project Manager: Jeremy Harris
-
(510) 560-4316
-
-
-
For any hazardous materials concerns contact:
-
Alameda County of Environmental Health
-
(510) 567-6700
-
-
For any hazardous materials concerns:
-
Bay Area Air Quality Management District
-
(800)-334-6367
-
-
Development updates provided via this website:
-
